Architecture, BIM & fit-out
Modelled before it's built
Selected work by our team · 2025Villa projects, for Bahat NajdSaudi Arabia

| Client | Villa projects, for Bahat Najd |
|---|---|
| Year | 2025 |
| Location | Saudi Arabia |
| Status | Selected work by our team |
| Services | Architecture, BIM & fit-out |
Design, quantities, programme and cost from one model: Revit for design and sheets, take-offs for pricing, and Primavera for the programme.
- Revit sheets and masterplans

- Blockwork plans and wall schedules

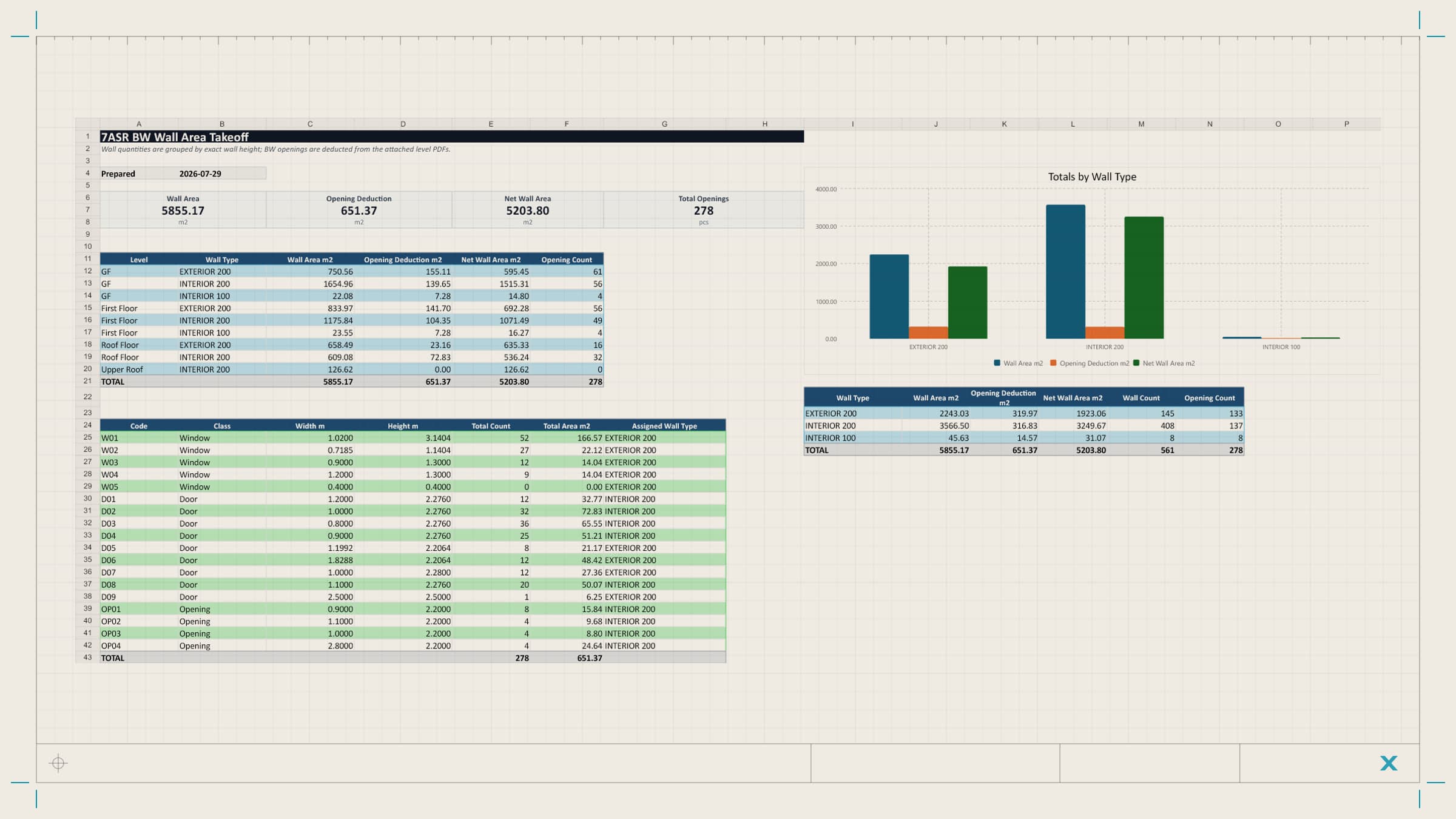

- Wall and openings take-off

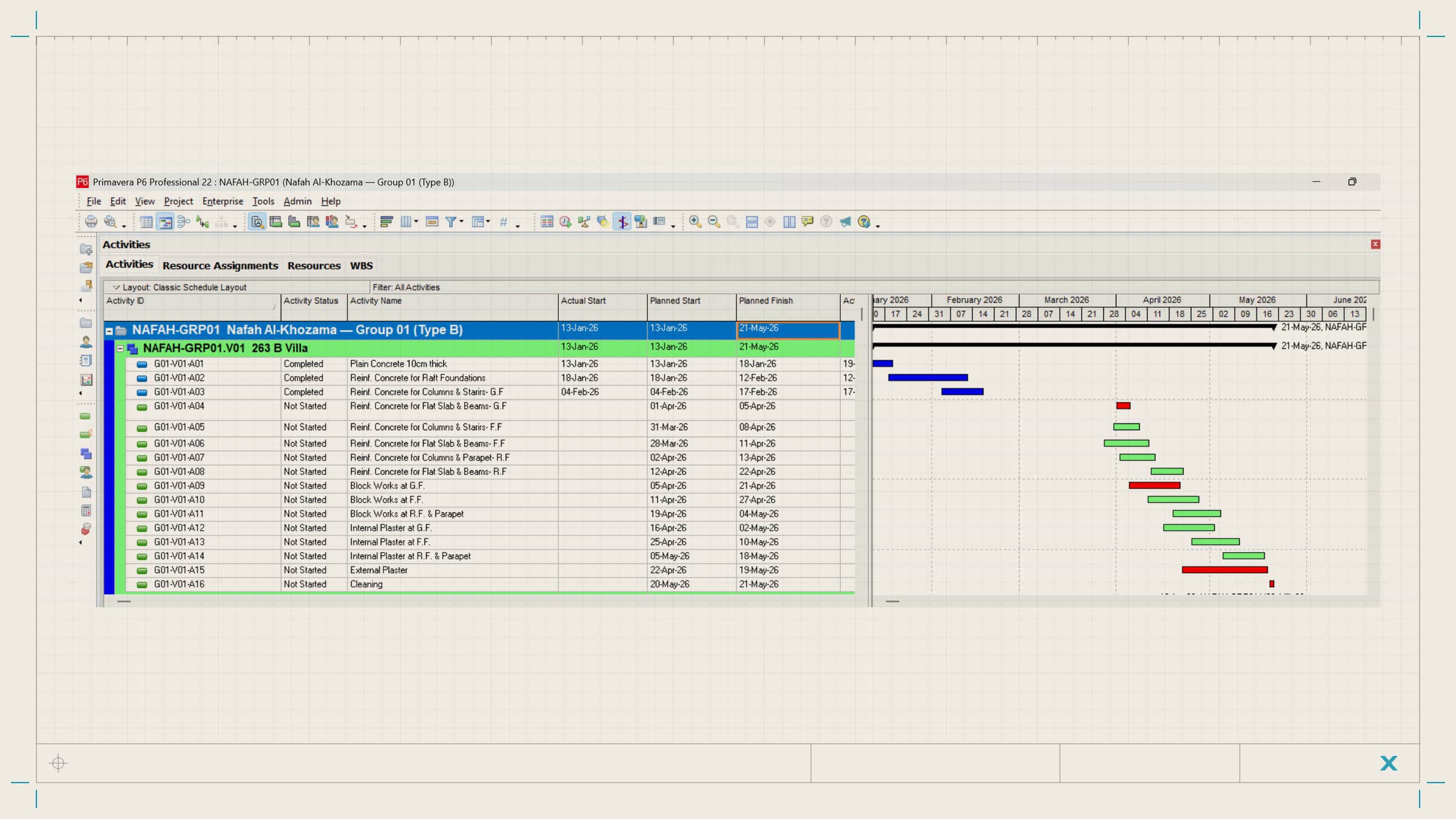

- Primavera P6 programme
